Building

Cabin build log

Building the home by hand, one step, one bag of concrete, one piece of lumber, and one piece of metal roofing at a time.

Build sequence · 2025–2027

Building our home in northern woods

When we first bought the land about five years ago, we had a lot of different ideas. We knew that we liked camping, we’d grown up with that in our lives. We knew that we liked the woods and we had a lot of ideas from our own life experiences and plenty of YouTube.

We knew that we wanted a place to be able to call home in the middle of the forest, but we didn’t know when we would build this nor did we know what it would look like.

After years of prep work, we’re hitting the ground running. We’re building our cabin and we’re getting it ready to live in full time. This page is going to talk about what we’re building and how we got here.

Jump to a build phase

2020–2025

Before the build

Five years of buying the land, learning it, and making it liveable enough to build on.

Open water and marsh grass at the edge of the property
01 / 06

"What if we bought a forest?" started as a half-joke during lockdown, then became a spreadsheet ranking size, water, distance, taxes, and utilities. The lot we bought was never on the list. It was raining, the driveway was overgrown, and it felt right anyway.

See the post ↗

Illustration of the orange Kubota BX23S tractor with loader and backhoe among bare trees
02 / 06

We bought a tractor before we built anything. A few weekends of shovelling the steep, bedrock-pinched driveway made the hand-tool plan look very silly, very fast. A contractor came to quote the job and sold us his Kubota BX23S instead.

See the post ↗

Illustration of the Kubota RTV utility vehicle and the tractor working together on a forest track
03 / 06

Deliveries only reached the edge of the property. The tractor could move it all a few hundred metres of rough road at a time, but slowly. The Kubota RTV X1100C hauls what the tractor loads and dumps it where it is needed.

See the post ↗

Illustration of the burnt-out generator beside its replacement under a snow-covered shelter
04 / 06

One winter morning I woke up cold and assumed the generator had run out of gas. It had caught fire overnight. My brother saw the glow, got the extinguisher, and stopped it there. That morning is a large part of why solar started looking so good.

See the post ↗

Illustration of solar panels propped beside the storage sheds and truck
05 / 06

A Victron system with LiFePO4 batteries, 400 W panels, a charge controller, and a 24 V layout we could maintain ourselves. Starlink, lights, tools, and the well pump now run without firing up the generator. The generator noise doesn't have to bother us anymore.

See the post ↗

Concrete greywater structure set into the pine woods with timber steps
06 / 06

A camper needs somewhere for the water to go. A Class 2 greywater system was the simple option, until the required capacity came out around 21,000 litres and the digging hit the Canadian Shield. Dig, hit rock, adjust, build upward, backfill, repeat, for three months.

See the post ↗

2020–May 2026

Imagining a home

From tents and a camper to plans for a full-time home in the woods. These posts look back at how the idea took shape.

Tarped shelters and a tent pitched among the trees in the early years on the land
01 / 03

A look back to what we had at first. The lot was vacant when we got it: an overgrown driveway and a well unused since the 80s. Tents, then insulated ice-fishing shelters, then an RV. Now a house for full-time living.

See the post ↗

Illustration of the travel trailer parked among autumn trees
02 / 03

After tents came the camper. The driveway had a bedrock hump right before a tight 90˚ turn, so the tractor got promoted: a three-point hitch adapter let us raise, lower, and ease the camper over the rock. Overnight the property had a place to arrive, sleep, cook, and leave things between visits.

See the post ↗

Render of the finished cabin with cedar siding, green tin roof, white trim, and a screened porch
03 / 03

A photorealistic render of the finished house, built from the architectural drawings: Canadian cedar siding, a green tin roof matching the other buildings, and white trim throughout.

See the post ↗

Cabin construction sequence

A house built by hand. The sequence below includes the work still ahead.

Illustrated sequence · includes planned work

  1. Open the groundThe tractor comes in. The bucket cuts into the soil and lifts it clear.
  2. Set the footingsFootings go down onto the prepared ground. Pier forms stand above them.
  3. Pour by handConcrete comes in a hand cart, tipped into the forms a load at a time.
  4. Build the floorBeams bridge the piers. Joists and the floor deck make a platform.
  5. Raise the wallsWall frames pivot upright, one section after another.
  6. Close in the roofTrusses rise into place, then the roof closes over them.
  7. Make it a homeSiding, windows, a door. The structure becomes a place to live.
Continue to the build diary ↓

May 2026

Clearing trees

Clearing what blocked the build, and anything that would lean toward the house once it stood.

A felled pine trunk bucked into lengths on the forest floor
01 / 04

Tree felling is a dangerous art, so a tree this size in the middle of the build came down with professionals. It will heat the place this winter.

See the post ↗

The tractor grading bare red earth at the cleared build site
02 / 04

Digging out the pier area. The piers embed directly into the bedrock of the Canadian Shield, so every stump has to come out whole — no plant matter between concrete and rock.

See the post ↗

A large root ball lifted out of the ground by the tractor
03 / 04

Multiple hands, a 4,500 lb winch on the RTV, and the tractor before this stump finally relented. Hard not to pause with each tree that comes down.

See the post ↗

Mounds of excavated earth and open stump holes across the build site
04 / 04

The site is nearly down to raw earth, roots, and bedrock. Every stump and pocket of soil says a little more about what the house will sit on.

See the post ↗

May–September 2026

Foundation

Footings meet the Canadian Shield. Digging, forming, and pouring took far longer than we planned.

A hand-dug pier hole cut through dark soil and roots
01 / 18

Machines do most of the work but lack the dexterity to finish a hole. Each pier gets hand-dug the rest of the way so the footing can be pinned to bedrock with rebar.

See the post ↗

Someone holding a tall measuring rod at the cleared build site
02 / 18

Measuring depth to grade across the site to work out how much sonotube, gravel, and dirt the foundation needs. Level here decides everything above it.

See the post ↗

The excavated foundation lit by machine lights after dark A timber footing form set into an open hole in the excavation
03 / 18

Work does not always stop when the sun goes down; in the heat you take the afternoon off and finish in the evening. Holes are dug and the forms are next. We all agree digging is the worst part of the build.

See the post ↗

Drilling rebar holes inside a footing form, wearing ear and eye protection
04 / 18

Drilling into the bedrock for rebar, which ties the concrete to the rock and protects against frost.

See the post ↗

A timber footing form seated on gravel in an excavated hole with string lines above A second footing form braced in a pit of red earth and gravel
05 / 18

Scribing each form to the bedrock underneath it, then bracing it so nothing moves when the concrete arrives.

See the post ↗

The tractor bucket pulling roots and rock out of the ground
06 / 18

Roots and rock in the spring woods, one careful bucket at a time. The ground gives up only what it has to.

See the post ↗

Lowering and squaring a footing form into its hole, seen from above
07 / 18

Lowering a footing box into its hole in light rain, then a plumb bob to mark centre. That is where we found the corner still needed digging — more lifting rocks than lifting dirt.

See the post ↗

Braced forms across the whole build site with the tractor parked at the edge
08 / 18

Ready for the first inspection, minus a handful of braces. A wild ride to get here, and the concrete pour is next.

See the post ↗

A plywood footing form built tight against exposed bedrock Rebar pins drilled into bedrock beneath a form board
09 / 18

A handful of piers ready for concrete. The inspector came out today; from the vibe, we passed.

See the post ↗

The formed foundation with the passed footing inspection record
10 / 18

Formally passed. Next week we pour concrete and build the real base of the house.

See the post ↗

A sonotube held in a timber bracing frame ready for concrete
11 / 18

Pouring week. Incredible to see the foundation take permanent shape, and a full-body workout is an understatement.

See the post ↗

A boom truck unloading pallets of concrete bags beside the shed
12 / 18

20,000 lb of concrete delivered in the morning, then a flash flood. A quick trip to Home Hardware for a pump kept the newly cured piers out of standing water.

See the post ↗

Poured concrete piers standing across the site under work canopies
13 / 18

The last footing and pier poured and stripped. Next: trenching between the footings, then gravel, geotextile fabric, drainage pipe, and sealing.

See the post ↗

Perforated drainage pipe run in a gravel trench between concrete piers Drainage pipe and gravel bedding carried around a pier
14 / 18

Drainage, insulation, and waterproofing nearly complete, with the final foundation inspection and backfill next.

See the post ↗

The finished piers and drainage under canopies in the forest clearing
15 / 18

The foundation drainage is in and has had plenty of rain to test it. Everything flows through without pooling, aside from the exit that still needs digging.

See the post ↗

The completed foundation with the passed foundation wall inspection record
16 / 18

Second inspection passed: the poured concrete, the drainage plan, and the insulation and waterproofing around the footings.

See the post ↗

Piers standing clear of fresh backfill with rigid insulation stacked nearby
17 / 18

After months of digging it out, time to fill it back in. Two thirds of what came out was rock, which cannot go back: rock moves in the freeze-thaw cycle and puts tremendous pressure on concrete. That's why we need "clean fill".

See the post ↗

The finished gravel pad with wrapped piers and saddles ready for framing A close view of a pier saddle bracket set in the gravel
18 / 18

The foundation is done. A final layer of geotextile fabric and gravel seals in and protects the base. Next we build up the floor.

See the post ↗

September 2026 – ongoing

Framing

Floors and walls rise one section at a time. After the foundation, everything moves quickly.

The laminated LVL centre beam laid out on the gravel pad
01 / 12

Half way through laminating the centre beam. This LVL beam carries the weight of the house.

See the post ↗

Beams set across the concrete piers, ready for the floor
02 / 12

Beams are up and we are ready for flooring. With the foundation done, it is coming together quickly.

See the post ↗

Floor joists framed across the piers in the forest clearing Pink batt insulation set between the floor joists
03 / 12

The floor is nearly done. After months of digging and concrete we are making quick work of it. Walls this week.

See the post ↗

The finished subfloor with tools out and the first wall sections standing
04 / 12

The floor is done and the walls are underway. Windows and doors are delivered and stored in the shipping container for now.

See the post ↗

Raising the last exterior wall section with ladders and framing crew
05 / 12

The last exterior wall has risen and the house starts to take shape.

See the post ↗

The framed exterior walls standing on the piers against autumn trees
06 / 12

The walls are up and ready for sheathing. Then an enclosed house and a deck off the front, interior walls, and the roof trusses.

See the post ↗

Exterior sheathing above the open joists of the front porch Sheathed cabin walls and front porch framing among autumn trees
07 / 12

Exterior sheathing and the front porch framing has been built. Up next we’ll finish the deck and build the interior walls to making raising the roof easier

See the post ↗

08 / 12

Finishing the deck to spec. Each board was carefully laid in our pre-set picture frame border and brings us one step closer to finishing up for the season before winter comes

See the post ↗

Interior wall frames dividing the rooms above the subfloor Framed doorway and interior partition walls inside the cabin
09 / 12

The interior walls have risen! Captured after a hard day’s work, these walls will see sound proofing and a mix of wood and drywall in the coming year. With these walls up, we are close to being able to close the roof in

See the post ↗

The first roof trusses raised above the exterior and interior walls
10 / 12

Let’s raise the roof 🙌 we are one step closer to being closed in for the winter

See the post ↗

11 / 12

Each truss is placed with care, secured in spot, and will be laterally braced soon

See the post ↗

All roof trusses standing above the sheathed cabin in the autumn woods Completed front porch decking beside a ladder against the cabin wall
12 / 12

We’ve raised all of the trusses, levelled, and attached them. The front porch deck is also done

See the post ↗

The trusses are up

All the roof trusses are raised, levelled, and attached, and the front porch deck is done. The next challenge is closing in the roof before winter.

As of

Next · October 2026 – March 2027

Winter break

We winterize the build and step away while the depths of the Canadian winter take hold, then start again when the winds warm.

Next · 2027

Interior finishes

Kitchen, bathroom, flooring, trim, electrical, plumbing, and insulation, slowly plugged away at.

The solar energy experiment covers the system already powering the site. For the finished house, we’re planning a solar extension with a permanent array and a new battery system.

Our vision for the property
  • This is a tentative plan we’ve been working on over the years. Much of it is already in place, some is in progress. The gardening areas, fruit trees, and cellar are yet to come.
  • The cabin sits off the main driveway, where desire paths have been carved into our roads.
  • We have two big pines that aren’t in our way. We’ve decided to keep them, and will monitor their health to ensure they don’t pose any risk to our buildings.
  • The implements attach to our tractor and RTV. They include a bush hog for clearing brush, a box blade for flattening, plows, and snow blowers.

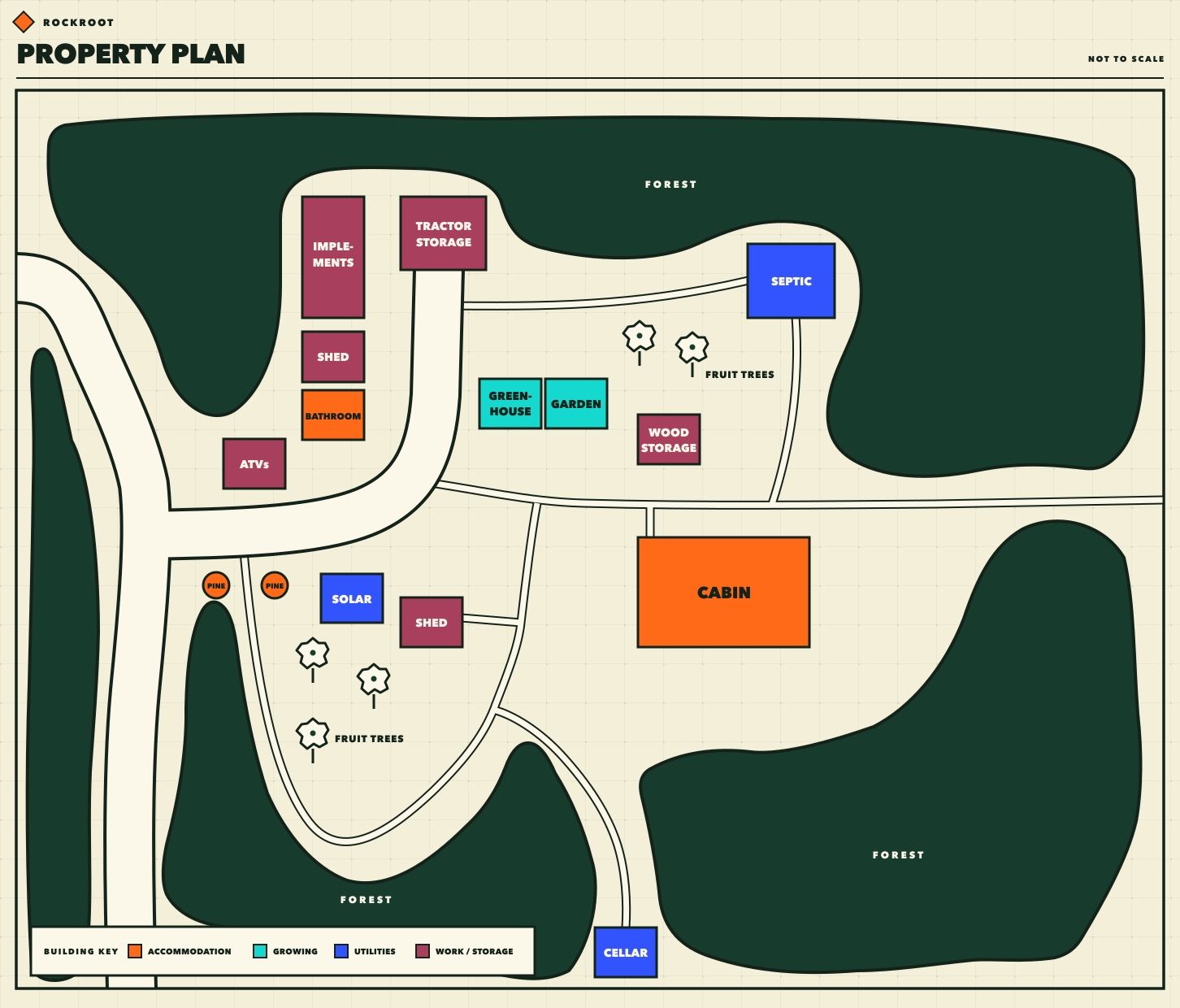

Property plan showing the cabin, driveway, trails, buildings, retained pine trees, and forest

Follow the build as it happens

Visit innorthernwoods.ca ↗

Follow on Instagram ↗

Conversation

Add a note.

Questions, corrections, and useful tangents are welcome. Sign in to join the conversation.
